The storm arrived on a Saturday night. The sump pump had been working for nine years and failed at some point in the early hours, either from the pump itself or from the power interruption; nobody established which afterward, which is worth noting because it did not matter to the claim.
By six in the morning there was roughly three inches of water across a finished basement of about nine hundred square feet: carpet, pad, drywall to the ceiling, a laundry area, and a room used as an office.
What follows is one loss, reconstructed from the documents it produced. Figures are rounded.
Day one: the order things happened in
Power to the basement circuits off at the panel before anyone went down the stairs. This is the step that gets skipped in the rush and it is the only one with a fatal failure mode.
Photographs before anything moved: every wall, the standing water, the pump, the electrical panel, each piece of furniture. Then a video walking the space.
The claim was opened by phone before eight. Two questions asked and answered on that call: whether emergency mitigation was covered, and whether the insurer wanted to send its own vendor. The answers were yes and no, which meant the homeowner could choose a mitigation company.
One thing was checked before any of that, in the policy: whether this was covered at all. Water entering because a sump pump failed is excluded from most base homeowners forms and covered by a water backup and sump overflow endorsement. It was on the declarations page, with a sublimit lower than the dwelling limit. That single line decided the entire outcome.
Days one to three: extraction and demolition
The mitigation crew arrived that afternoon. Extraction first, then the removals.
Carpet and pad came out entirely. Pad holds water and is inexpensive; carpet in a category one loss can sometimes be saved, but the pad never is, and here the carpet went too because it had been sitting for hours.

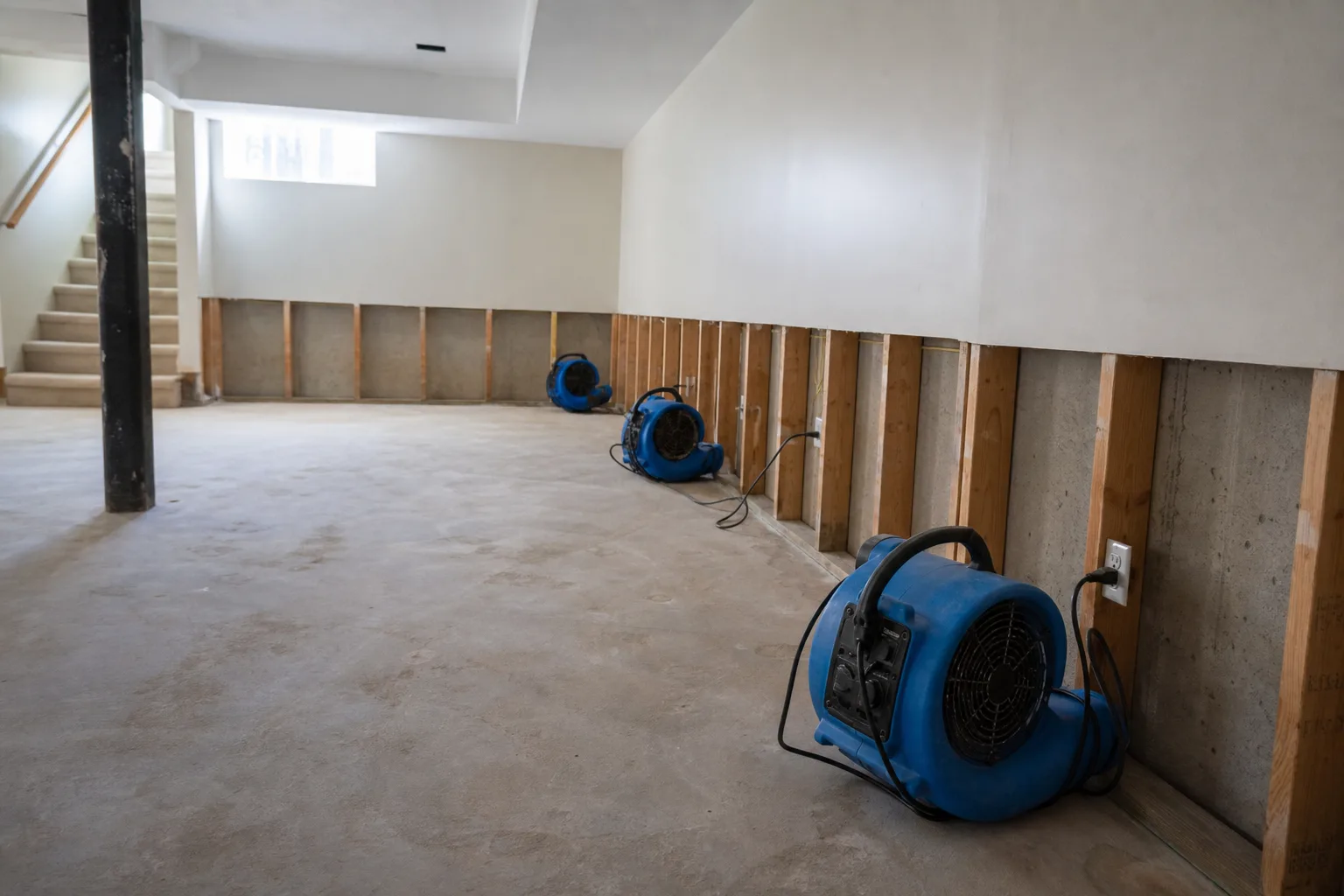

Then flood cuts: drywall removed to a line above the visible water, in this case at two feet, along with the insulation behind it. Wet insulation inside a wall will not dry in place and is the single most common reason a wall stays wet for weeks while the surface reads dry.
Baseboard came off. The bottom plate, the studs and the subfloor were left exposed to the room, which is the point of the cuts.
By the end of day three the space held eight air movers and two commercial dehumidifiers, running continuously. The electricity for that is not trivial and it is a reimbursable cost, which is worth asking about because most homeowners never think to.
Days four to eleven: the daily log
The crew took readings every day: relative humidity in the space, and moisture content in the framing and the subfloor at marked points. They also took readings in an unaffected part of the basement, which becomes the number everything else is judged against.
That baseline is the most important thing in the file. Wood in a house is never at zero. What matters is whether the affected material has come back to roughly what comparable material in the same building reads, and without a baseline there is no way to say.
By day seven most of the room was close. Two areas were not: the wall behind the laundry, where a built-in cabinet had held water against the drywall, and a section of subfloor under where the office desk had stood.
Day twelve: the scope disagreement
The adjuster's initial scope proposed replacing drywall to two feet, new pad and carpet, new baseboard, and paint on the affected walls. It did not include the built-in cabinet, and it treated the subfloor as drying rather than as requiring replacement.
The contractor's estimate included removing the cabinet, replacing a section of subfloor, and painting the walls to the ceiling rather than to a line, on the basis that a two-foot band of new paint on a nine-year-old wall does not match.
The gap between the two was several thousand dollars.
Days twelve to twenty-two: what actually resolved it
Not argument. Two readings.
The first was the moisture content behind the built-in cabinet, taken after the cabinet was pulled far enough forward to get a probe behind it. It read well above the unaffected baseline on day twelve, nine days into aggressive drying, which established that the assembly was not going to dry in place with the cabinet there.
The second was a set of readings across the subfloor section, showing a persistent high area that had not moved in four days despite equipment directly on it. Material that stops responding to drying is material with a problem behind it, and when the section was lifted the tongue and groove had swelled at the joints.
Both were photographed with the meter in frame, dated, and sent with the log. The revised scope came back within a week including the cabinet, the subfloor section, and full-height paint on two walls. The insurer declined full-height paint on the other two and that was accepted, because it was a reasonable line to draw and the household had run out of appetite for the conversation.
Equipment came out on day twenty-two, when three consecutive days of readings matched the baseline. Not when the room felt dry, which was somewhere around day six.
The office, and what happened to the contents
Contents were handled as their own part of the claim, and they split into three groups.
Things that were clearly finished: the pad and carpet, a fabric sofa that had sat in water overnight, two particle board bookcases that swelled at the base within a day, and a quantity of cardboard boxes whose contents were mostly paper.
Things that were saved by being moved fast: a desk lifted onto blocks on the first morning, filing that came upstairs wet and was spread on a kitchen table under a fan, and a hard drive that had not been powered on since the water arrived and read normally two days later.
And the group that took judgment: photographs, a box of documents and some artwork. Those went into a freezer that afternoon, which stops the deterioration where it is and buys weeks to deal with them one at a time. Most were recovered.
Every discarded item was photographed at the curb with a note of what it was and roughly when it had been bought. That list, made in the first three days, is what the contents settlement was built from a month later.
Where the twenty-two days actually went
Worth setting out, because the calendar is not intuitive.
Days one to three were extraction and demolition, which is the visible part and the part people assume is most of it. Days four to eleven were equipment running with nobody on site except for a daily reading, which feels like nothing happening and is where the drying is actually done. Days twelve to eighteen were the scope disagreement, during which the equipment kept running because stopping it would have restarted the clock. Days nineteen to twenty-two were confirmation: three consecutive matching readings before anything came out.
Reconstruction started after that and took another six weeks, most of which was waiting on a flooring product rather than on labor.
What the numbers looked like
Mitigation, which is the emergency phase, ran to a five-figure sum on its own and was billed directly to the insurer. Reconstruction was larger. Contents were a separate part of the claim with its own settlement, and the endorsement's sublimit ended up being the binding constraint rather than the estimates.
The deductible applied once. The household was out of pocket for that, for the electricity, and for a portion of contents settled at actual cash value rather than replacement cost, which is a line on the policy nobody had read in nine years.
What was done differently afterward
A second sump pump with a battery backup, on its own float at a slightly higher level, which is a few hundred dollars and addresses both failure modes that were candidates for the original.
A water alarm on the floor near the pit, which is inexpensive and would have turned a six-hour flood into a one-hour one.
The rebuilt lower wall was finished with a paperless board and the new baseboard was set on a small gap, so the next event, if it comes, is a cleanup rather than a demolition.
And the household kept the drying log. It is the document that answered every question in this claim, and it will answer the first question anyone asks about the basement at the point the house is sold.
